Hello,
I am trying to get this formula to work and it is currently working for tasks completed on time or late and showing the correct # of days in between, but for tasks completed ahead of the expected finalization date it is not working and that is a mathematical issue as the "-1" I added in my formula to calculate the in between dates is adding to the number of days when a task is completed earlier. How can I solve this issue? Any ideas on a formula I can add so it understands that for tasks completed earlier (negative
the -1 is not being added?

WORKDAY_DIFF({Expected Finalization Date},{Actual Finalization Date})-1
Page 1 / 1
Hi Lily,
There's probably a shorter way to do this using Switch, but here's a solution that should work:
IF(WORKDAY_DIFF({Expected Finalization Date},{Actual Finalization Date})-1>0,
WORKDAY_DIFF({Expected Finalization Date},{Actual Finalization Date})-1 & " days left.",
IF(WORKDAY_DIFF({Expected Finalization Date},{Actual Finalization Date})-1<0,
"Finished early!",
IF(WORKDAY_DIFF({Expected Finalization Date},{Actual Finalization Date})-1=0,

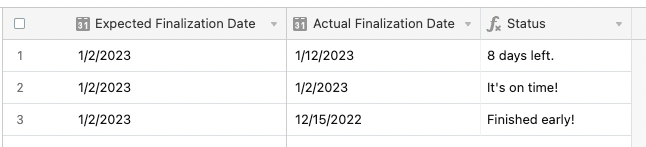

"It's on time!",
""
)
)
)


Hi Lily,
There's probably a shorter way to do this using Switch, but here's a solution that should work:
IF(WORKDAY_DIFF({Expected Finalization Date},{Actual Finalization Date})-1>0,
WORKDAY_DIFF({Expected Finalization Date},{Actual Finalization Date})-1 & " days left.",
IF(WORKDAY_DIFF({Expected Finalization Date},{Actual Finalization Date})-1<0,
"Finished early!",
IF(WORKDAY_DIFF({Expected Finalization Date},{Actual Finalization Date})-1=0,
"It's on time!",
""
)
)
)


Hi @Ron_Daniel this is great, thank you! Now what about if I want to know the # of days only per task? Like 2 days late or 3 days early? What I am looking is the delta so that I can access if tasks are completed on time and for the ones late or early, are those late or early by X # of days, if that make sense?
